2026.09

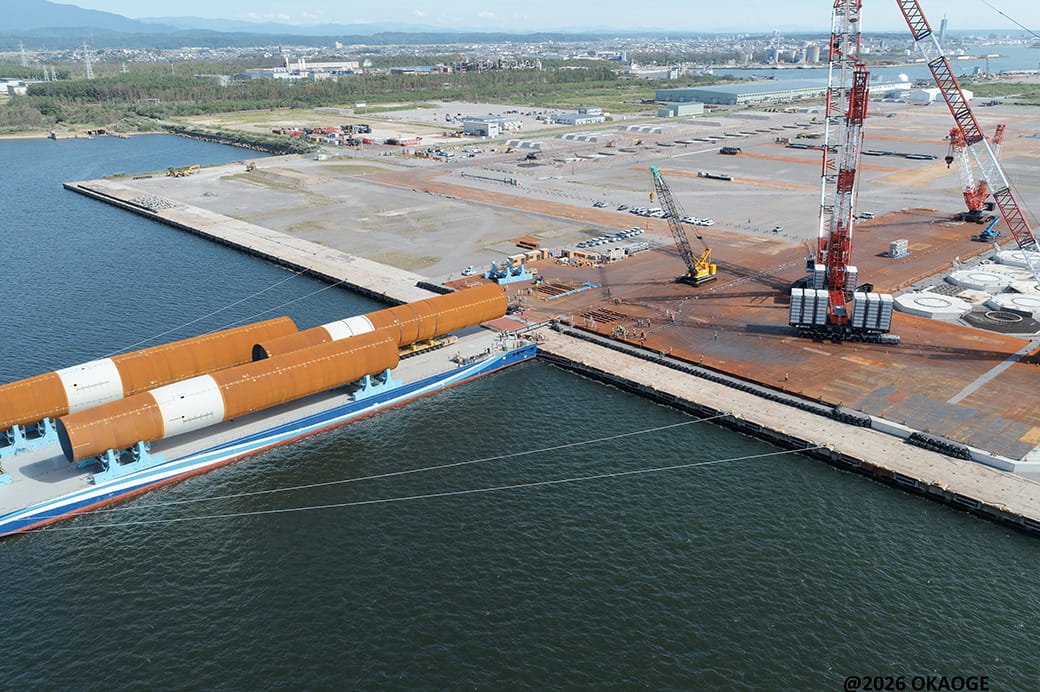

The unloading of MPs (monopiles) has commenced. Major wind turbine components have arrived at Akita Port for the first time.
Preparations for upcoming offshore construction are underway at the port.
2026.09
The unloading of MPs (monopiles) has commenced. Major wind turbine components have arrived at Akita Port for the first time.
Preparations for upcoming offshore construction are underway at the port.
2026.05

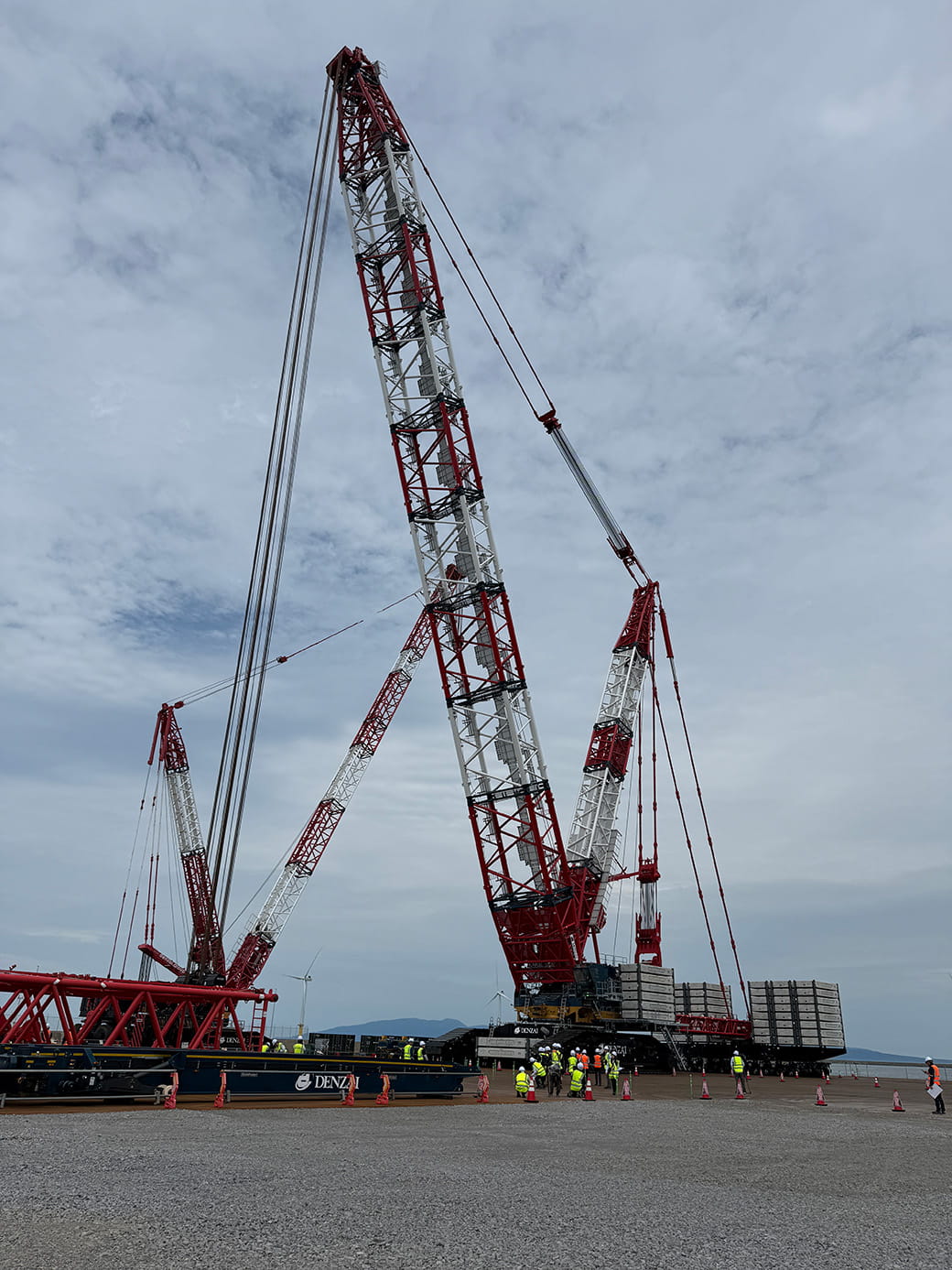

The erection of a 2,500-ton crawler crane has been completed.
Preparations are underway for the upcoming assembly of wind turbine components.
2026.05
The erection of a 2,500-ton crawler crane has been completed.
Preparations are underway for the upcoming assembly of wind turbine components.
2026.05

The Akita Port Office has been completed and is now in operation.
It is being utilized as a local base to support offshore construction work.
2026.05
The Akita Port Office has been completed and is now in operation.
It is being utilized as a local base to support offshore construction work.
2025.08
Site preparation at the base port has been completed. Ground improvement work will now begin in earnest.
The necessary workspace has been prepared for receiving and assembling wind turbine components.

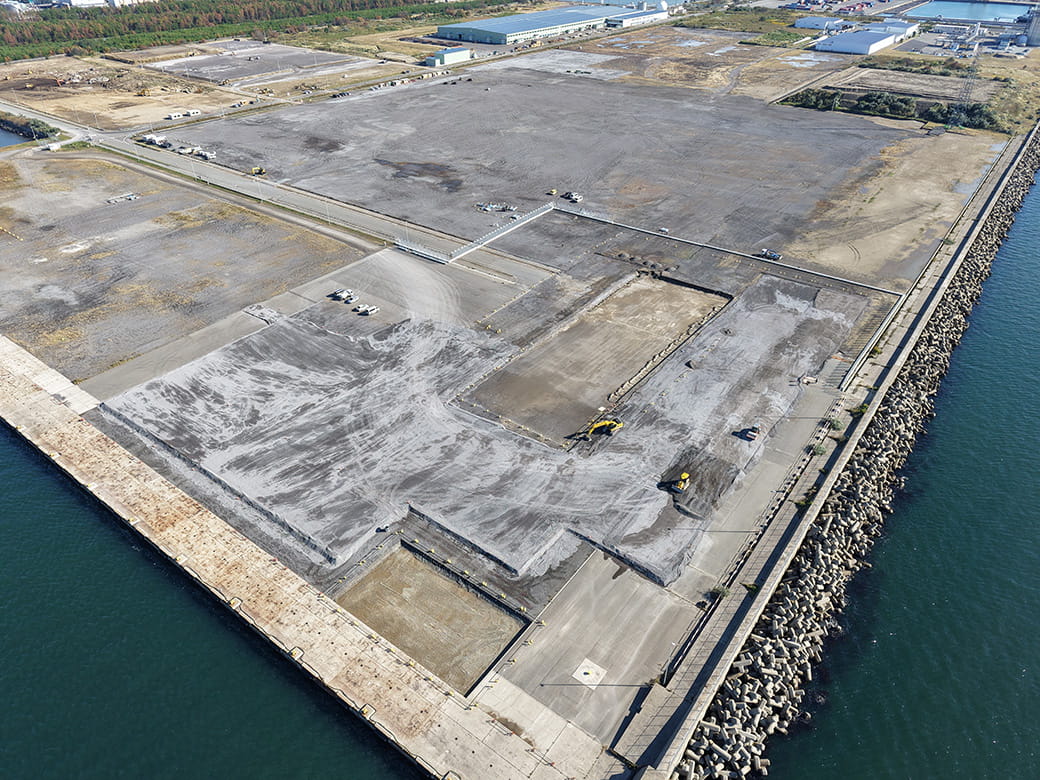

2025.08
Site preparation at the base port has been completed. Ground improvement work will now begin in earnest.
The necessary workspace has been prepared for receiving and assembling wind turbine components.
2025.04

Base port operations have commenced. Moving forward, it will be utilized as a hub for receiving wind turbine components and conducting offshore construction work.
2025.04
Base port operations have commenced. Moving forward, it will be utilized as a hub for receiving wind turbine components and conducting offshore construction work.
