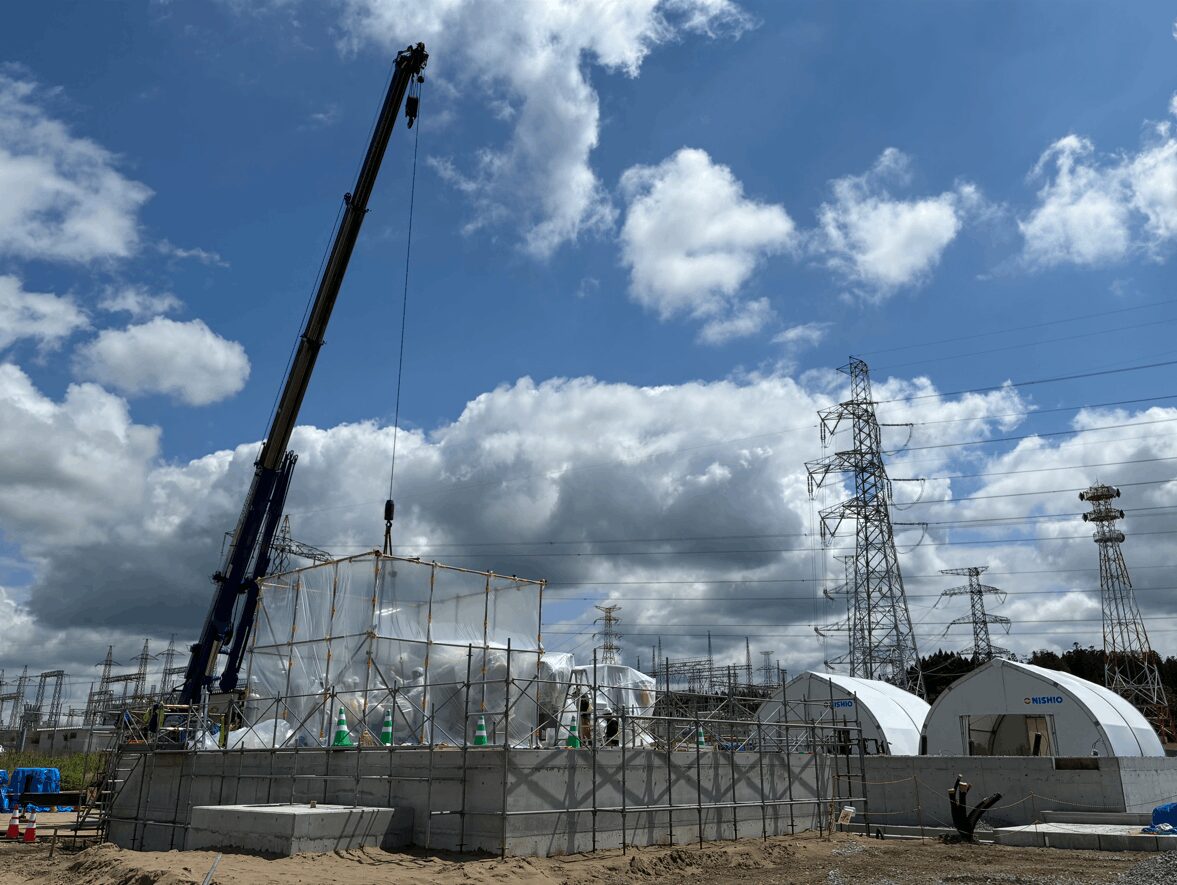

2026.07
As part of the switching station construction, equipment assembly is underway on the completed foundations.
2026.07
As part of the switching station construction, equipment assembly is underway on the completed foundations.

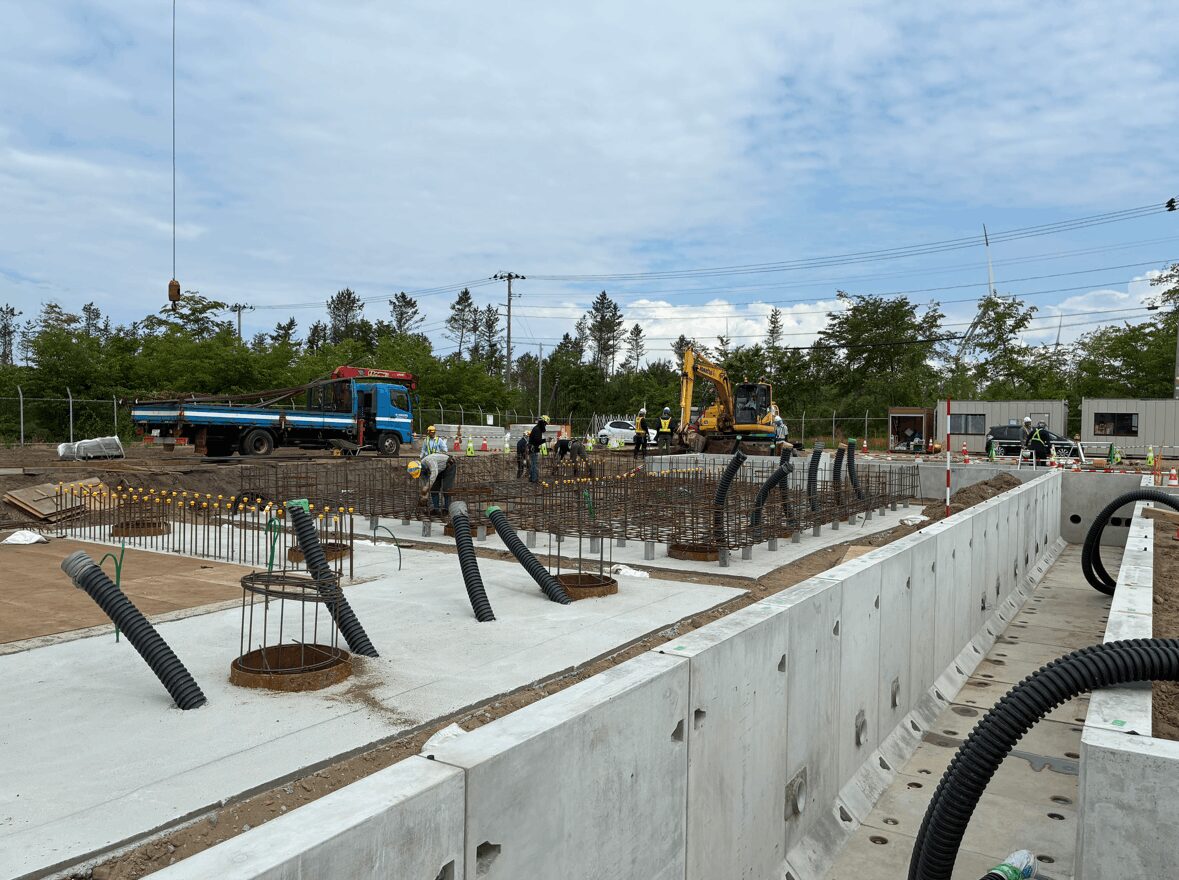

2026.06
As part of the substation construction, foundation work is underway for the installation of equipment.
2026.06
As part of the substation construction, foundation work is underway for the installation of equipment.

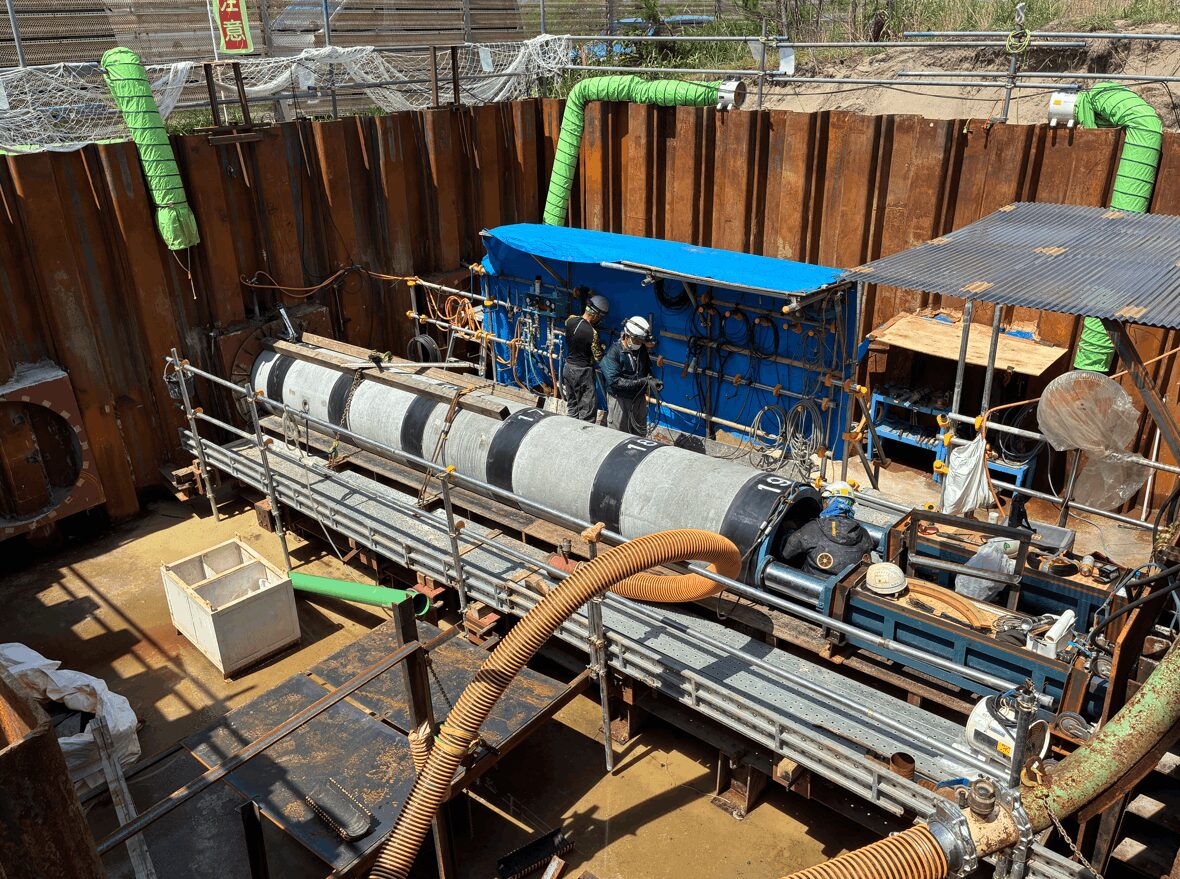

2026.05
As part of the onshore transmission line construction, pipe jacking work is underway in preparation for pulling the submarine cables onshore.
2026.05
As part of the onshore transmission line construction, pipe jacking work is underway in preparation for pulling the submarine cables onshore.

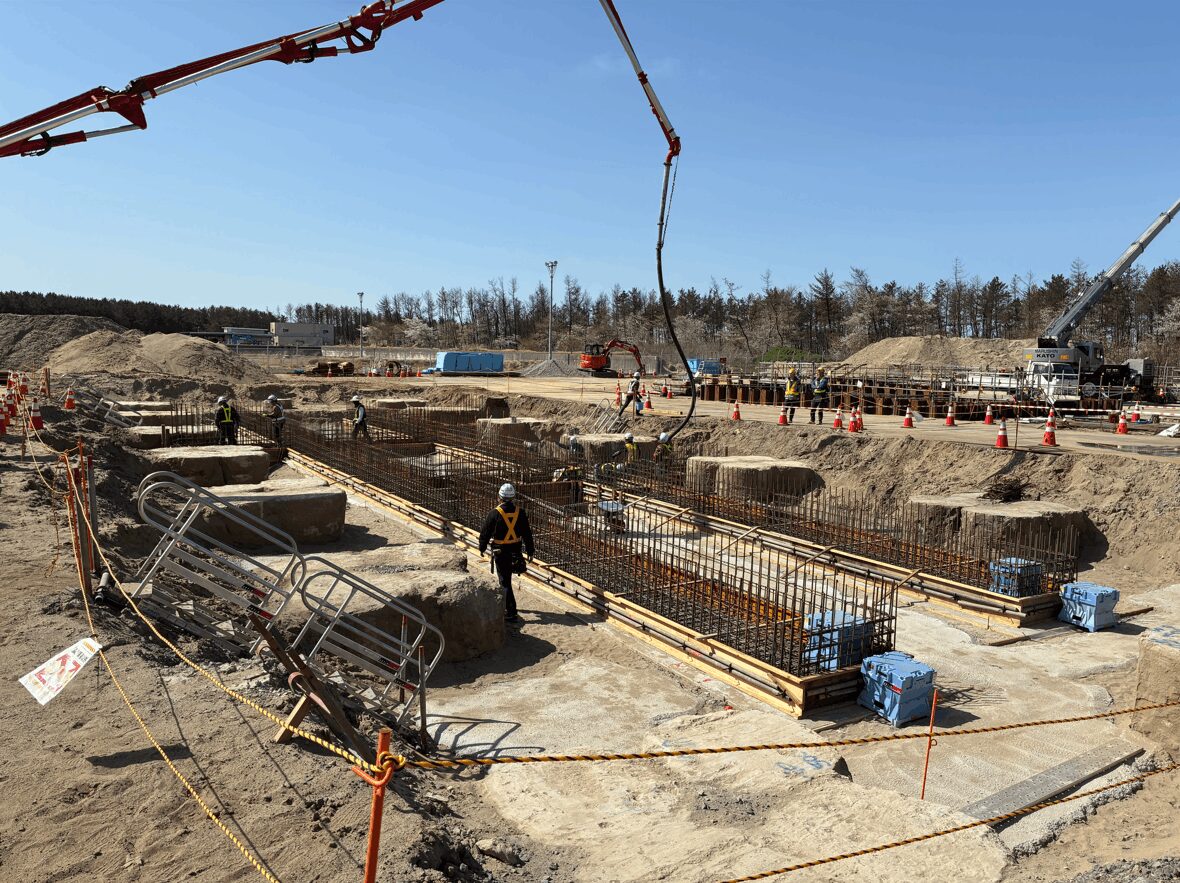

2026.03
As part of the substation construction, foundation work is underway for the installation of equipment.
2026.03
As part of the substation construction, foundation work is underway for the installation of equipment.

2026.02
As part of the onshore transmission line and substation construction, power cables are being laid through underground manholes and cable conduits.
2026.02
As part of the onshore transmission line and substation construction, power cables are being laid through underground manholes and cable conduits.

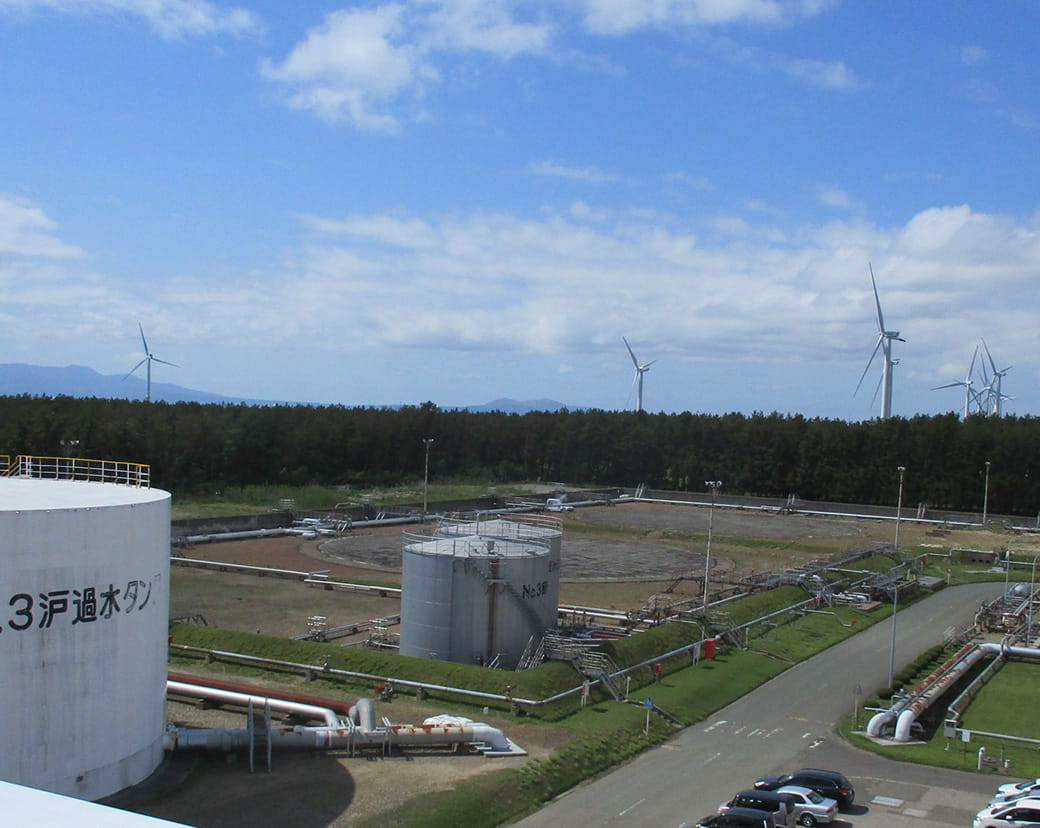

2025.08
Substation construction has commenced. Equipment installation is underway to connect the wind farm to the transmission grid.
2025.08
Substation construction has commenced. Equipment installation is underway to connect the wind farm to the transmission grid.

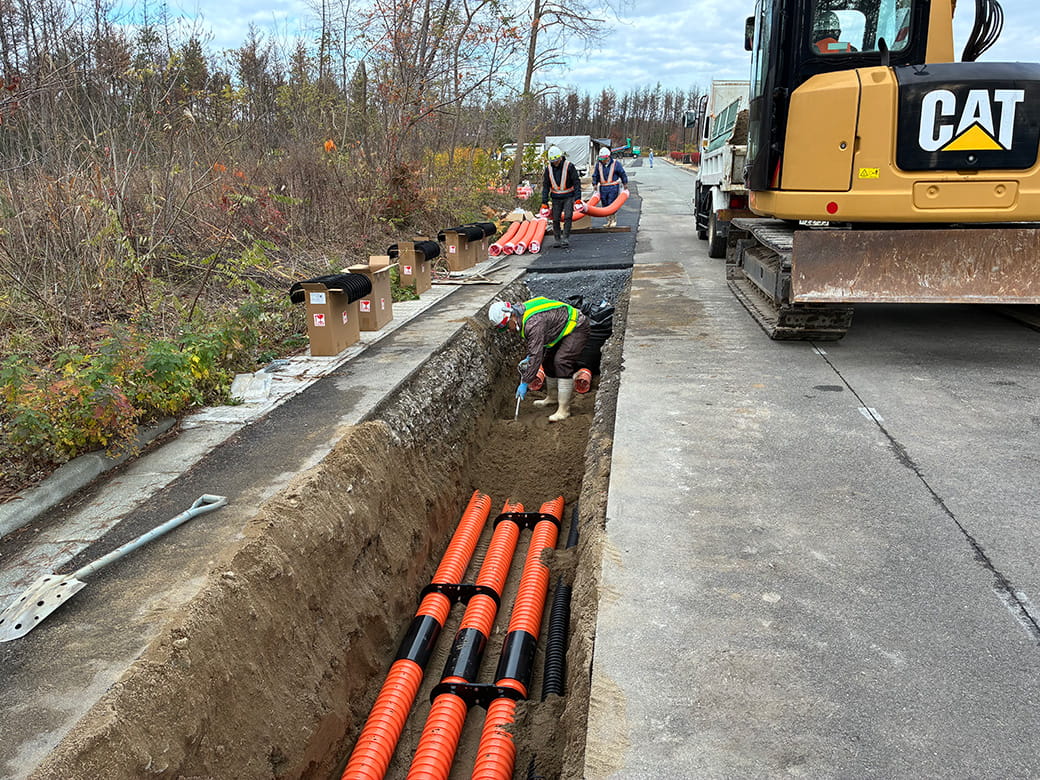

2025.06
Onshore transmission line and substation construction has commenced. Conduit burial work is currently underway, followed by manhole construction and cable laying.
2025.06
Onshore transmission line and substation construction has commenced. Conduit burial work is currently underway, followed by manhole construction and cable laying.
